Construction Updates
We’re proud to share that the perfect place to build your dream home is taking shape before your eyes.
Under Construction

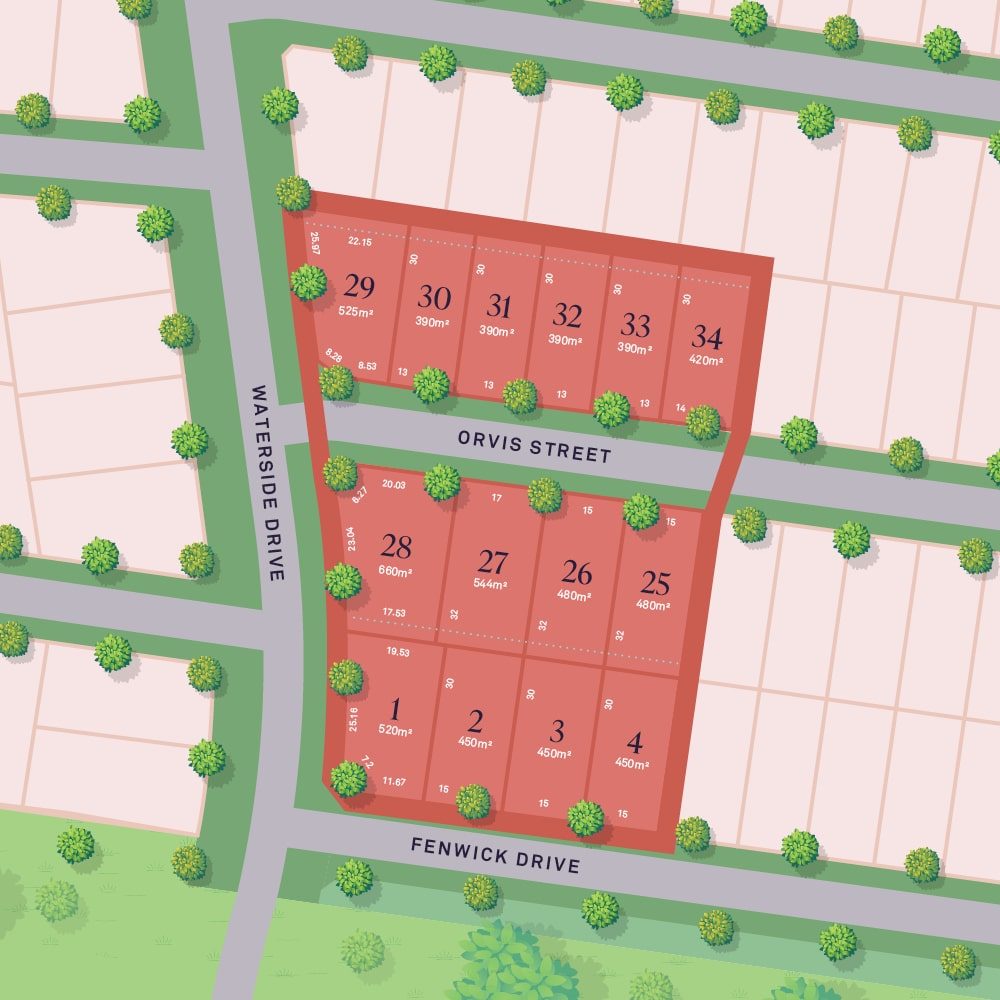

Stage 1A
Est. Titles Due
Q2 2026
Est. Settlement Due
Q3 2026
Works95%
Site EstablishmentJun-25
Bulk EarthworksJul-25
Sewer ReticulationSep-25
DrainageNov-25
Water ReticulationJan-26
Subgrade Placement WorksFeb-26
Electrical and NBNMar-26
Footpaths/ Ashpalt/ Line MarkingApr-26
Practical CompletionJun-26
Registration
Statement of ComplianceJul-26
Lodge Plan of SubdivisionJul-26
Estimated TitlesAug-26
Estimated SettlementsAug-26

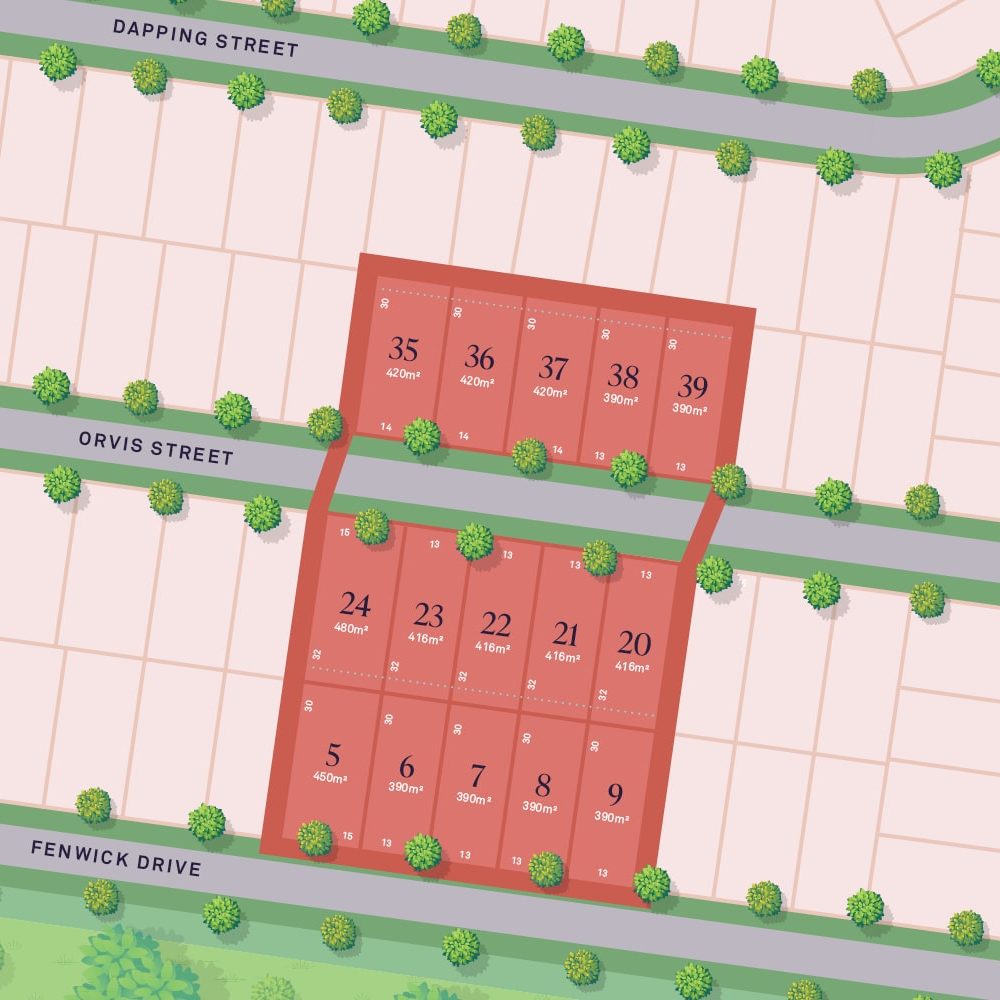

Stage 1B
Est. Titles Due
Q2 2026
Est. Settlement Due
Q3 2026
Works95%
Site EstablishmentJun-25
Bulk EarthworksJul-25
Sewer ReticulationSep-25
DrainageNov-25
Water ReticulationJan-26
Subgrade Placement WorksFeb-26
Electrical and NBNMar-26
Footpaths/ Ashpalt/ Line MarkingApr-26
Practical CompletionJun-26
Registration
Statement of ComplianceJul-26
Lodge Plan of SubdivisionJul-26
Estimated TitlesAug-26
Estimated SettlementsAug-26

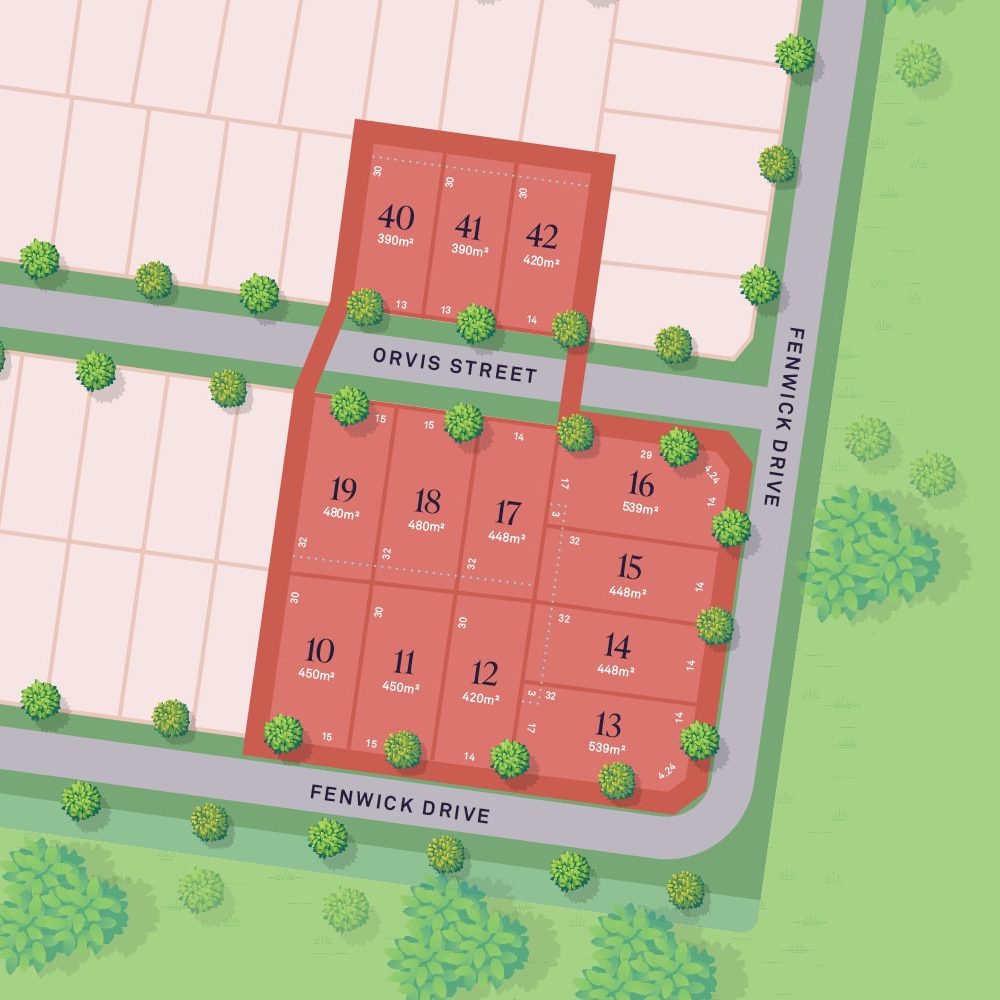

Stage 1C
Est. Titles Due
Q2 2026
Est. Settlement Due
Q3 2026
Works95%
Site EstablishmentJun-25
Bulk EarthworksJul-25
Sewer ReticulationSep-25
DrainageNov-25
Water ReticulationJan-26
Subgrade Placement WorksFeb-26
Electrical and NBNMar-26
Footpaths/ Ashpalt/ Line MarkingApr-26
Practical CompletionJun-26
Registration
Statement of ComplianceJul-26
Lodge Plan of SubdivisionJul-26
Estimated TitlesAug-26
Estimated SettlementsAug-26

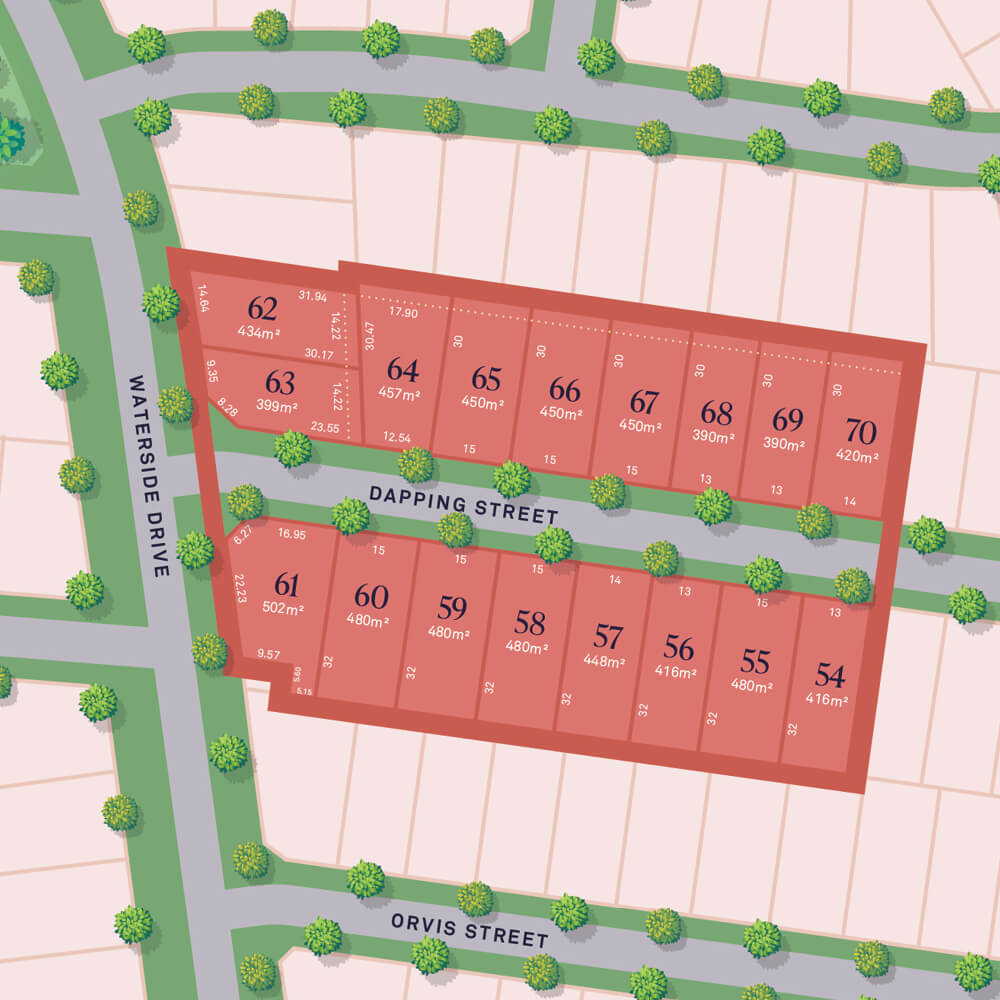

Stage 2A
Est. Titles Due
Q1 2027
Est. Settlement Due
Q1 2027
Works20%
Site EstablishmentJun-26
Bulk EarthworksJun-26
Sewer ReticulationJul-26
DrainageAug-26
Water ReticulationSep-26
Subgrade Placement WorksSep-26
Electrical and NBNOct-26
Footpaths/ Ashpalt/ Line MarkingNov-26
Practical CompletionDec-26
Registration
Statement of ComplianceJan-27
Lodge Plan of SubdivisionFeb-27
Estimated TitlesMar-27
Estimated SettlementsMar-27
Stage 1A
Works95% Site EstablishmentJun-25 Bulk EarthworksJul-25 Sewer ReticulationSep-25 DrainageNov-25 Water ReticulationJan-26 Subgrade Placement WorksFeb-26 Electrical and NBNMar-26 Footpaths/ Ashpalt/ Line MarkingApr-26 Practical CompletionJun-26 Registration Statement of ComplianceJul-26 Lodge Plan of SubdivisionJul-26 Estimated TitlesAug-26 Estimated SettlementsAug-26
Stage 1B
Works95% Site EstablishmentJun-25 Bulk EarthworksJul-25 Sewer ReticulationSep-25 DrainageNov-25 Water ReticulationJan-26 Subgrade Placement WorksFeb-26 Electrical and NBNMar-26 Footpaths/ Ashpalt/ Line MarkingApr-26 Practical CompletionJun-26 Registration Statement of ComplianceJul-26 Lodge Plan of SubdivisionJul-26 Estimated TitlesAug-26 Estimated SettlementsAug-26
Stage 1C
Works95% Site EstablishmentJun-25 Bulk EarthworksJul-25 Sewer ReticulationSep-25 DrainageNov-25 Water ReticulationJan-26 Subgrade Placement WorksFeb-26 Electrical and NBNMar-26 Footpaths/ Ashpalt/ Line MarkingApr-26 Practical CompletionJun-26 Registration Statement of ComplianceJul-26 Lodge Plan of SubdivisionJul-26 Estimated TitlesAug-26 Estimated SettlementsAug-26
Stage 2A
Works20% Site EstablishmentJun-26 Bulk EarthworksJun-26 Sewer ReticulationJul-26 DrainageAug-26 Water ReticulationSep-26 Subgrade Placement WorksSep-26 Electrical and NBNOct-26 Footpaths/ Ashpalt/ Line MarkingNov-26 Practical CompletionDec-26 Registration Statement of ComplianceJan-27 Lodge Plan of SubdivisionFeb-27 Estimated TitlesMar-27 Estimated SettlementsMar-27
